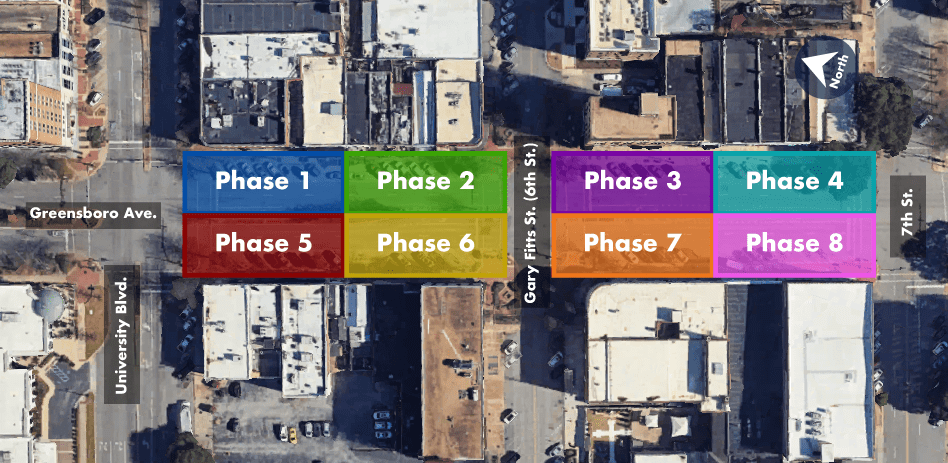

Progress:
The Phase 1 and Phase 2 work areas are substantially complete. The northbound lane of Greensboro Avenue, the adjacent bay parking and the sidewalk between Gary Fitts Street and University Boulevard were reopened during the evening of Friday, June 5.

Next Steps:
- Demolition, utility and new sidewalk work will continue in Phase 3 and Phase 4
- Gas relocation continues in Phase 7 and Phase 8 work areas and will be completed next week
Upcoming impacts:
- Northbound lanes of Greensboro Avenue between 7th Street and Gary Fitts Street are closed within the Phases 3-4 work areas
- The sidewalk corridor along the east side of Greensboro will remain open between 7th Street and Gary Fitts Street with shifts as work continues at building entrances
- The sidewalk south of The Trunk is currently closed between The Trunk and 7th Street adjacent to the vacant buildings
- The northeast quadrant of the Greensboro and 7th Street intersection will be closed between The Shirt Shop and Swag from Monday June 29 – Sunday July 5, pending the 7th Street closure is able to open prior to June 29
- The westernmost southbound lane and adjacent parking between Gary Fitts Street and 7th Street will be closed due to gas relocation in Phase 7 and Phase 8 work areas
Pedestrian and local business access will remain open during the duration of the project.
For more information, visit tuscaloosaroads.com/Greensboro.
