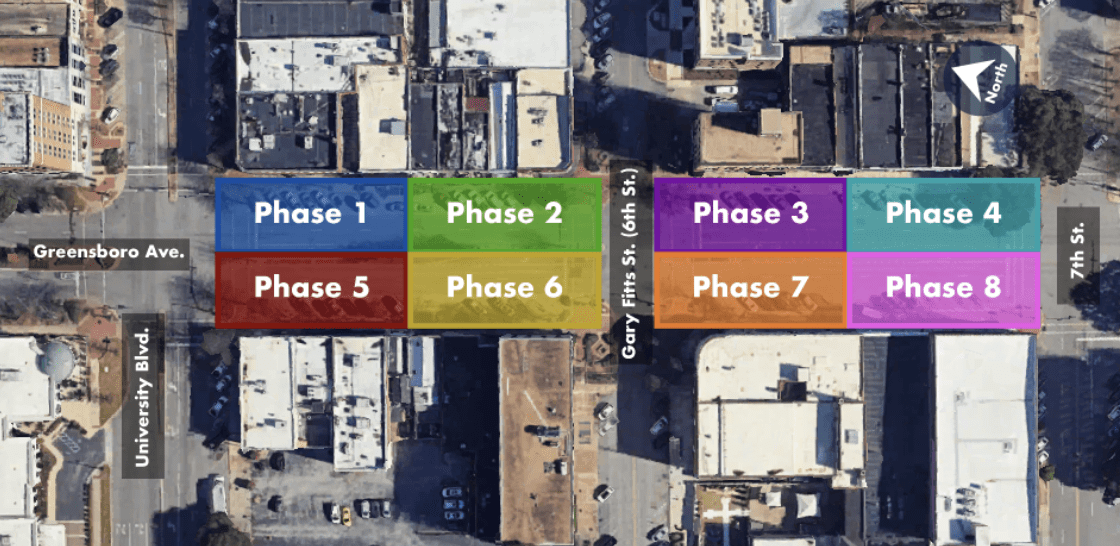

Progress:

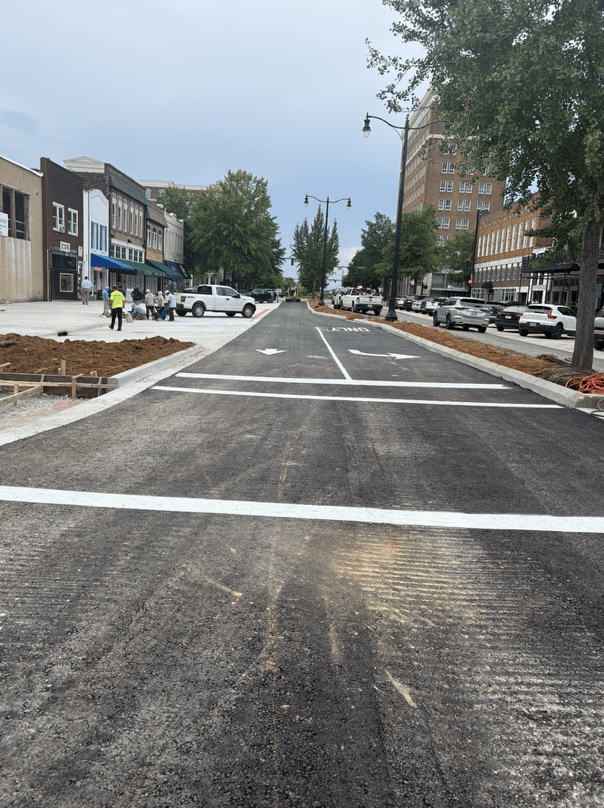

Phase 1, Phase 2, Phase 3, Phase 4, Phase 5 and Phase 6 work areas are substantially complete. The southbound lane, sidewalk and adjacent bay parking of Greensboro Avenue in the Phase 5 and Phase 6 work areas was reopened on Monday, August 10. Storm drainage in the Phase 7 and Phase 8 work areas will be complete by Friday, August 14.
Next Steps:
Work in the Phase 7 and Phase 8 work areas will continue. Landscaping work on the east side of Greensboro Avenue is scheduled to begin during the week of August 24.
Upcoming Impacts:
The southbound lane of Greensboro Avenue between 7th Street and Gary Fitts Street is closed within the Phase 7 and Phase 8 work areas.The majority of the sidewalk corridor will remain open along the west side of Greensboro Avenue between 7th Street and Gary Fitts Street.
Pedestrian and local business access will remain open during the duration of the project.
